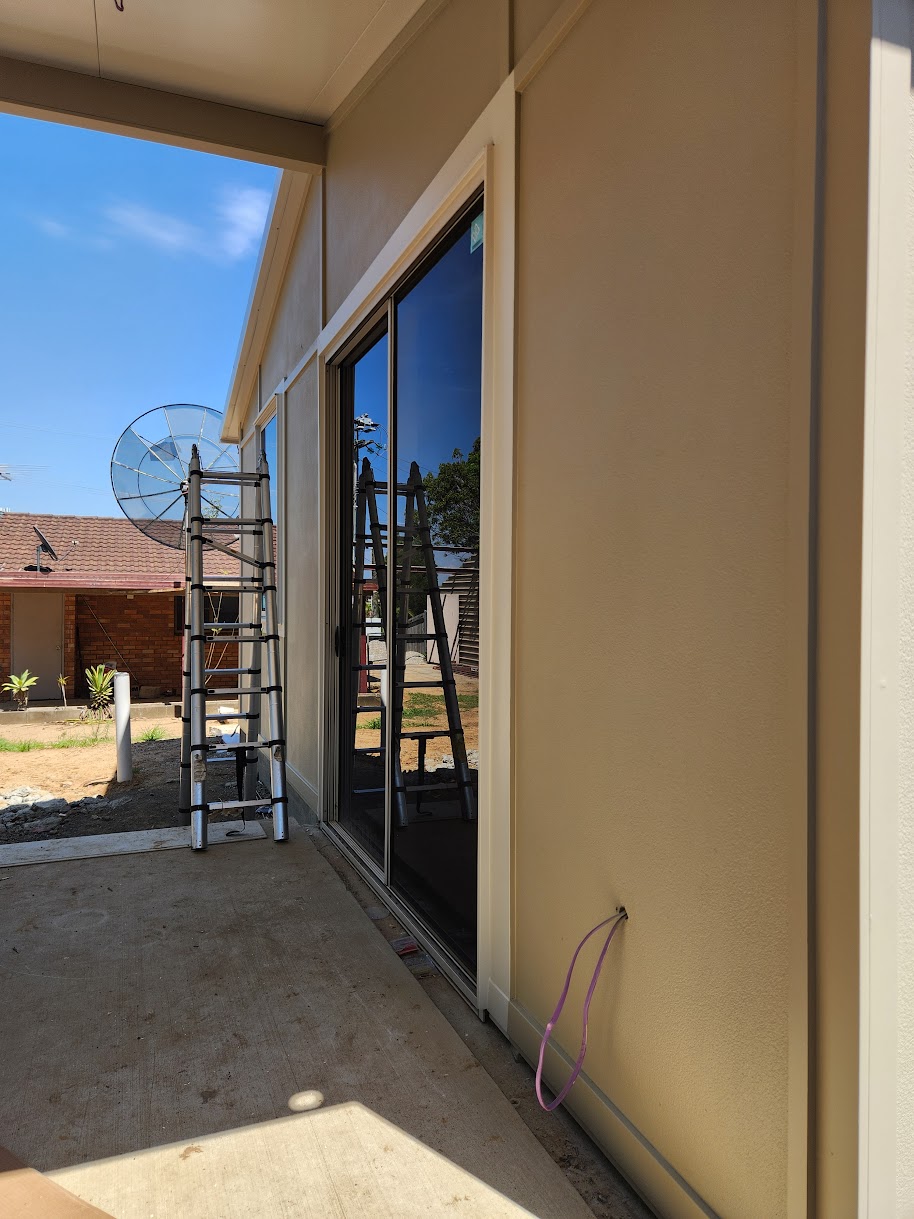

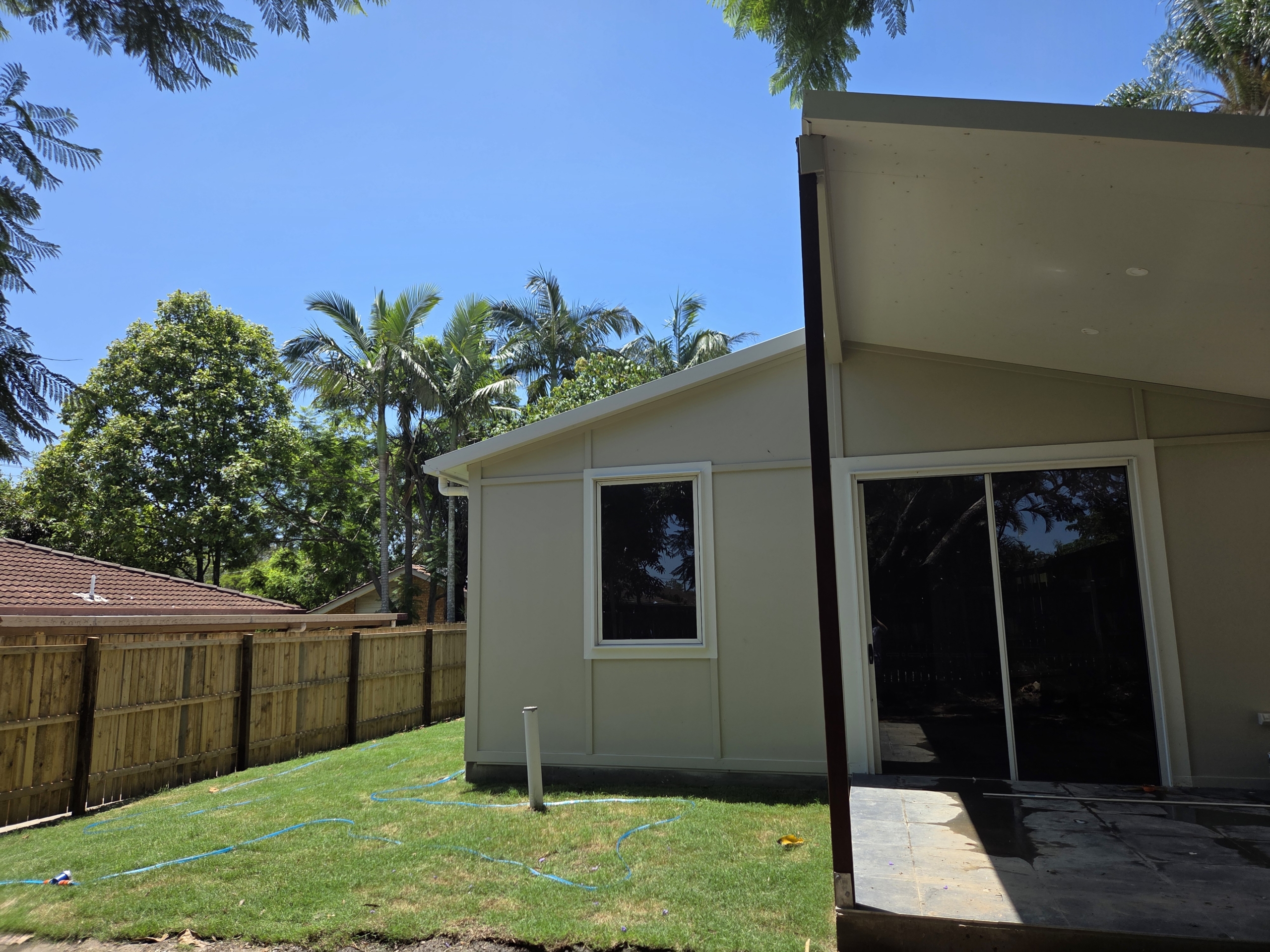

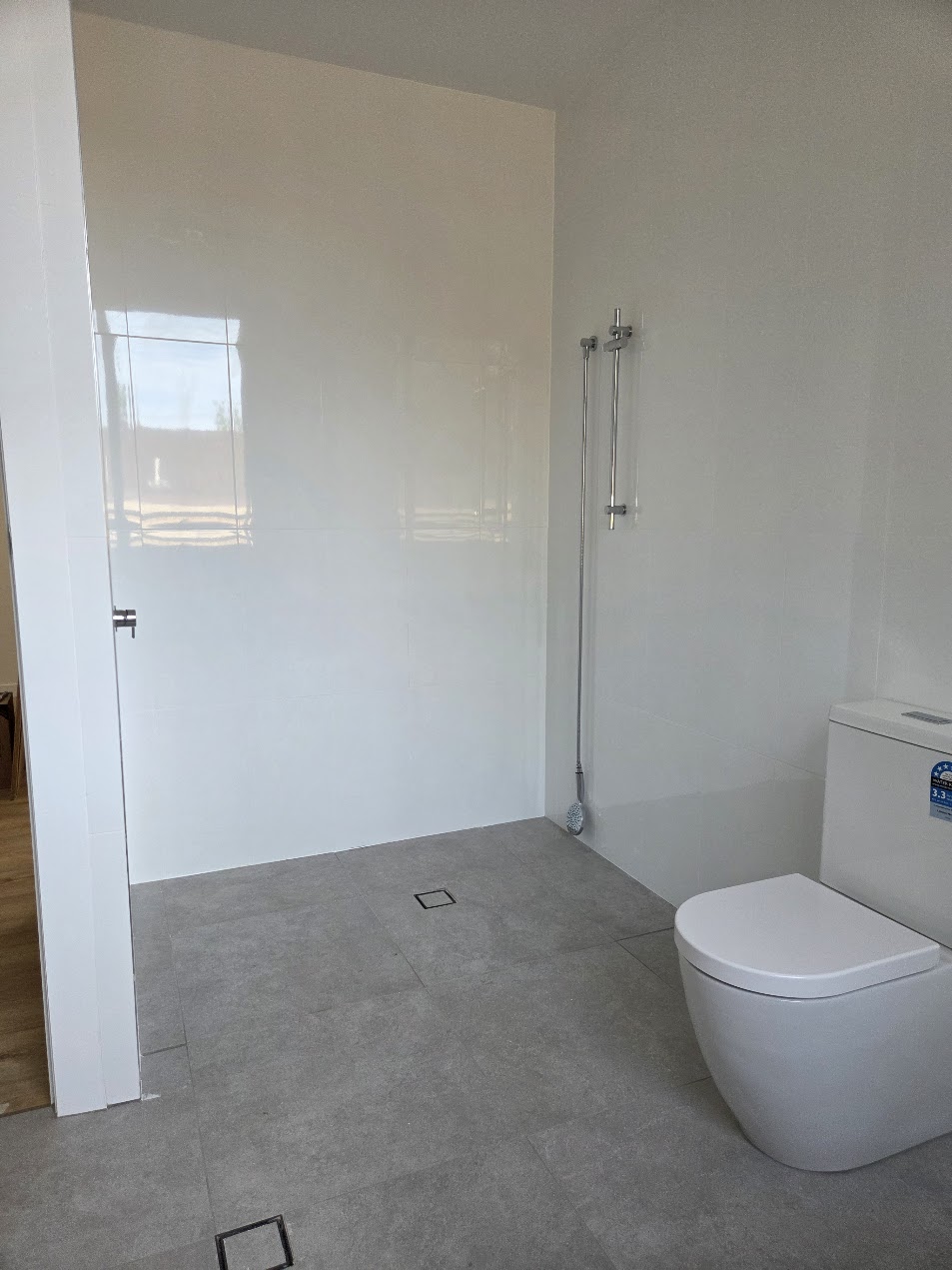

Our week 9 has ended and this is what we achieved: Commencement of painting works:Sanding has been completed, and the next step will involve waterproofing the wet areas along with painting. Continuation of external cladding:Gutter installation has been completed and is ready for downpipe installation. General update:Some works experienced minor delays this week due to sequencing and coordination...
CONSTRUCTION UPDATES
Plastering works are currently progressing, with the ceiling already installed and villaboard joint setting underway.The plumbing rough-ins for both the kitchen and laundry areas have also been finalised. Week 9 – Planning Starting Monday, 13th October We are expecting the following works to take place: ✓ Wet area waterproofing.✓ Continuation of external cladding.✓...
This week, the plumbing rough-ins have been completed, although some adjustments are still required. Painting and fit-out works have been postponed to next week. Ceiling sheets were delivered on Friday. Week 8 (planned) – Starting on Tuesday 7th (Monday is a Public Holiday) The plan includes: ✓ Adjustments to plumbing rough-ins ✓Fit-outs, and plastering. We’ll keep you informed as soon as...

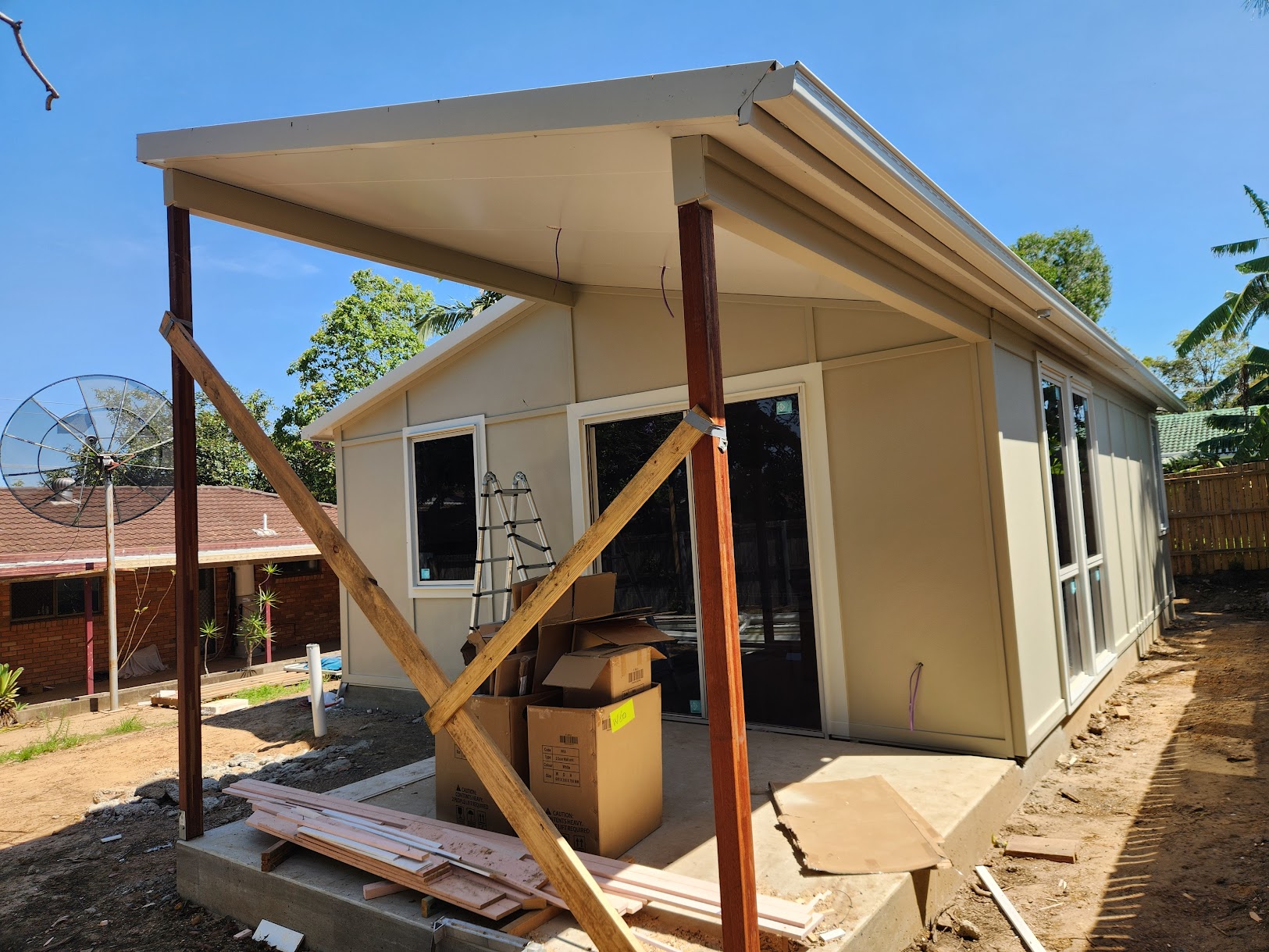

Week 6: Windows, Beadings, and Electrical Works This week, the windows were installed together with the exterior beadings, and the electrical connections for the interior were completed. Next week, works will progress with plumbing, plastering, and painting. The project remains on track, with completion expected by Week 10, towards the end of...
Week 5: Roof installation finalised This week, the team successfully completed the roof installation on schedule. The project is progressing well, with no delays to date. With the walls and roof now in place, next week’s works are expected to commence with the rough-in for electrical and plumbing installations, as well as the installation of window frames and exterior panel beadings....
Week 4: Fence Completion, Roof Delivery, and Wall Installation This week, Stage 1 of the fence was completed. Stage 2 will follow, finalising the new boundary fence that will separate the two dwellings. The Bondor roof was delivered, and wall installation commenced on Tuesday. As part of the system, a bottom plate was required to support the wall panels—our team completed the bottom plates on...
Week 3: Slab and Panel Delivery This week, the modular panels were delivered to site. The concrete works for the slab were completed, and the posts for the new fence were poured at the same time. Next week’s works are planned to include completion of the new fence and the erection of walls for the granny...
Week 2: Footings and form work This week, the footings were concreted and the formwork was completed. The termite inspection was successfully passed. The slab is now ready for concreting. Works on the slab and the new fence are scheduled to commence next week (Week...
Week 1: Site Preparation and Earthworks This week the site was prepared and earthworks were completed. Due to the ground movement, the existing fence has been compromised and will be replaced. Next week, foundation works will commence with the concreting of the footings and...
